2025 Road Reconstruction

Phase 3 - Road Reconstruction | July 14 - August 1, 2025

Vendors

  • Frank Civil Consulting
  • MR Tanner

Updates from the Owners Association

  • Village Specific Communications:
    • Coming Soon

Frequently Asked Questions

Scope of Project

The SMOA is working with MR Tanner, and Frank Civil Consulting, the same consultants who assisted the SMOA on the first two phases of road reconstruction in 2023 and 2024.

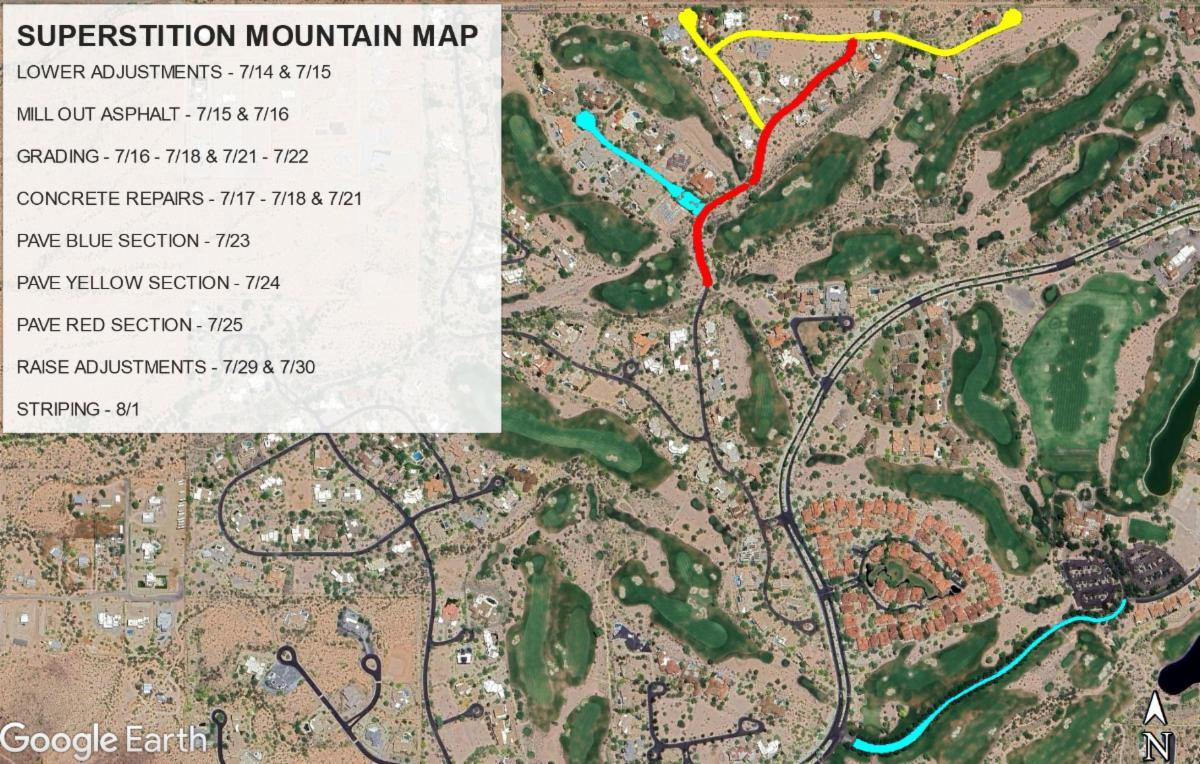

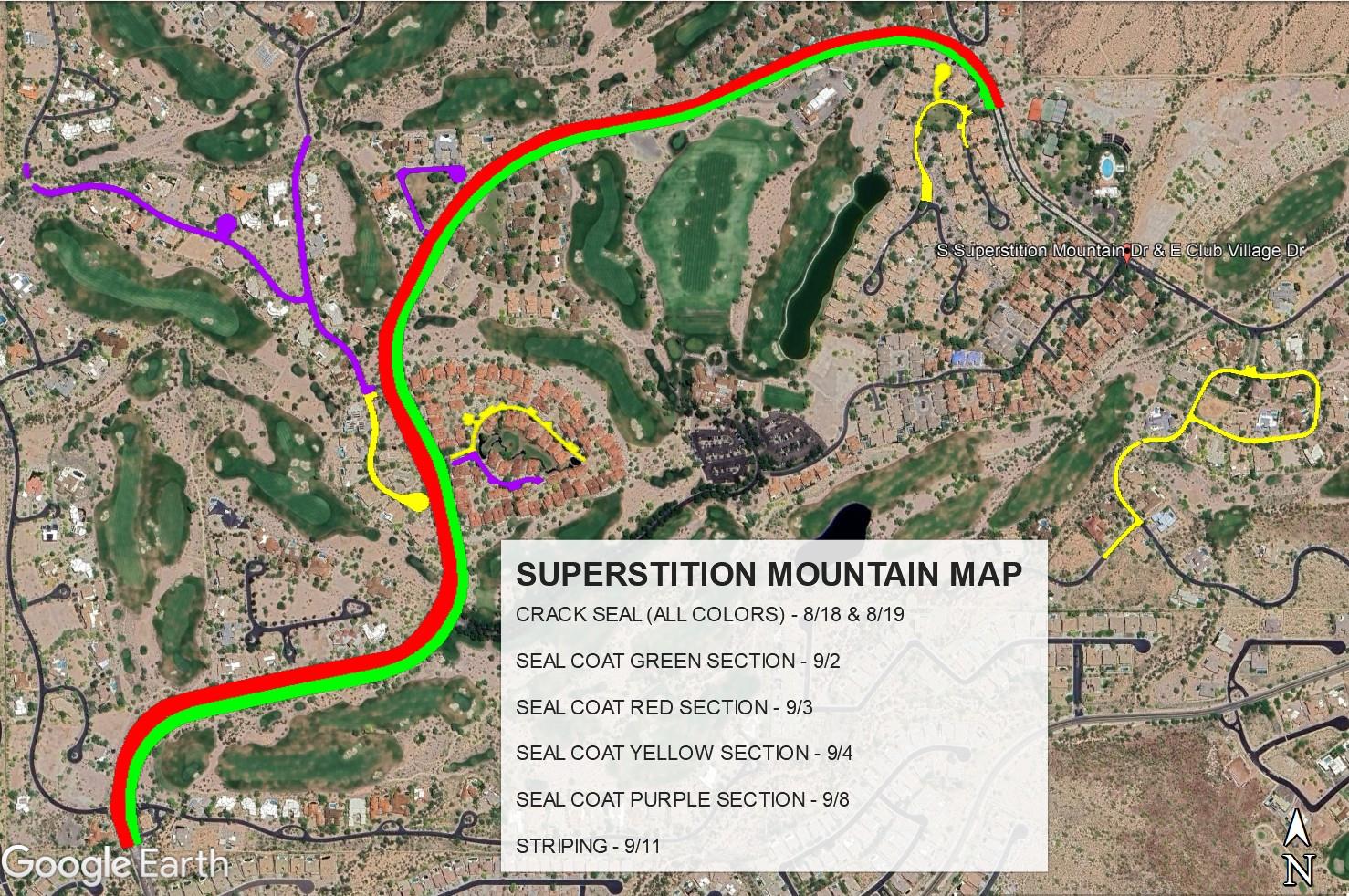

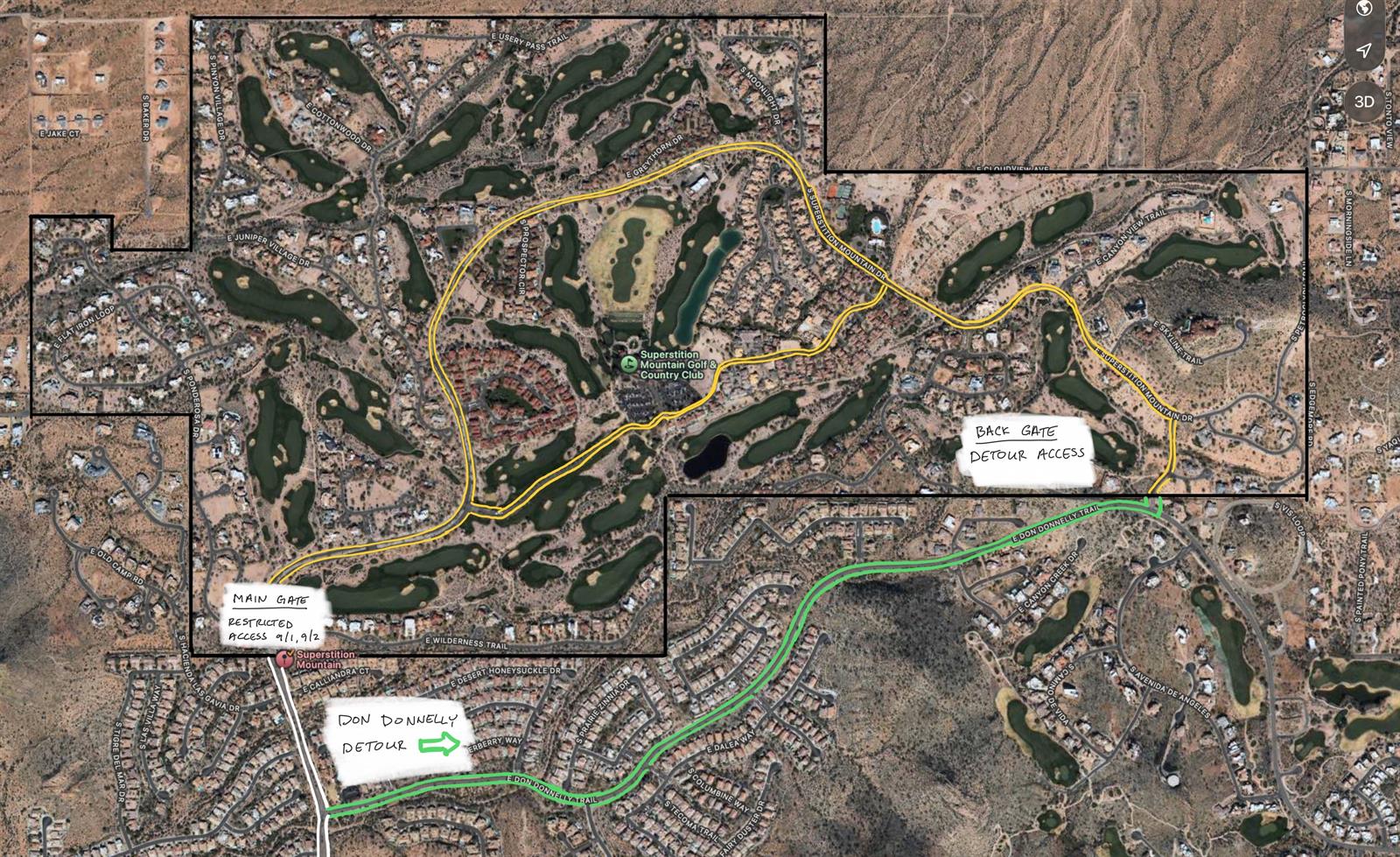

This project phase will cover Club Village Dr (from the Superstition Mountain Drive to just pass the entrance into Club Village) and the roads in Cottonwood, Sycamore, and Sycamore Village Drive from Juniper to Usery Pass as highlighted on the map below.

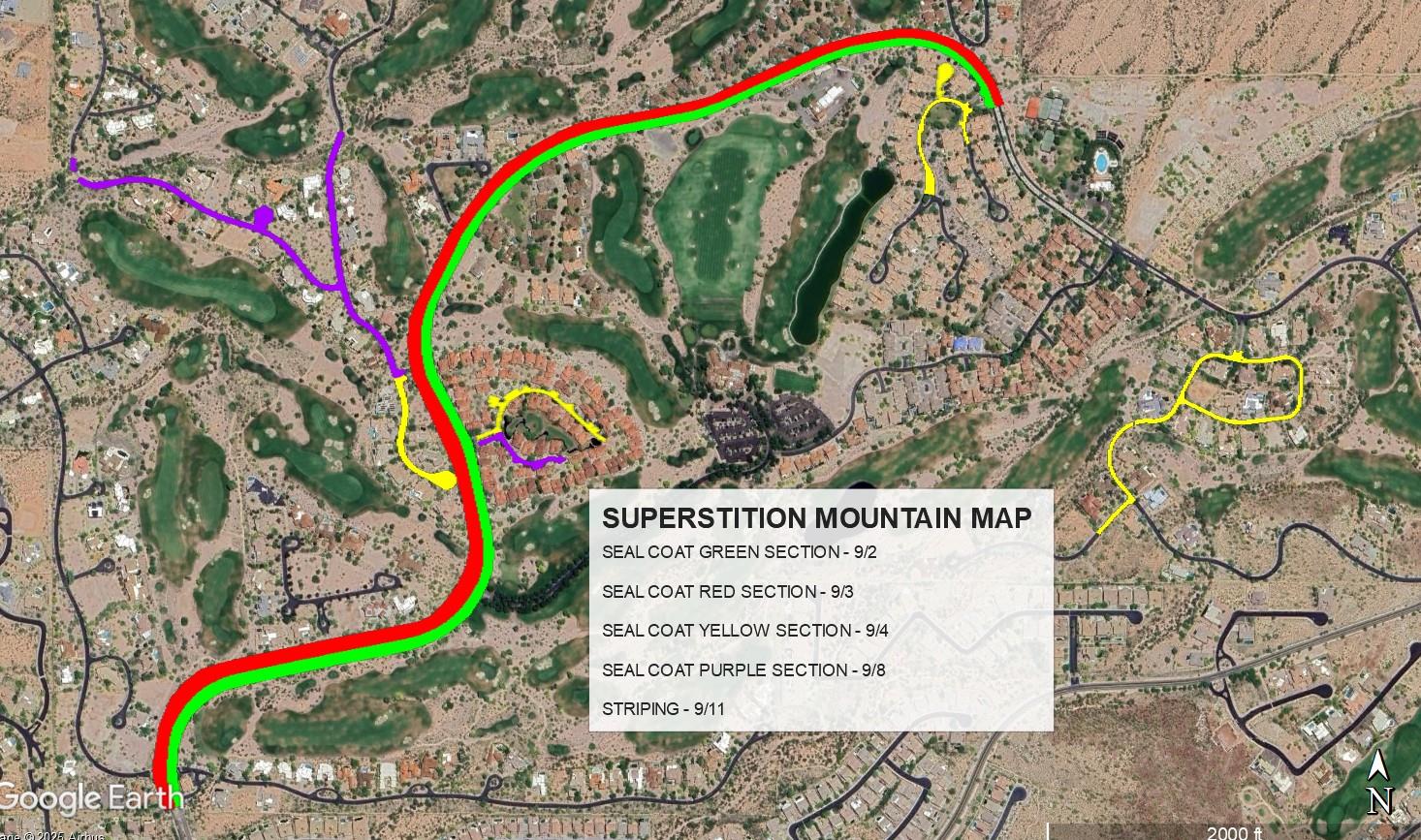

Superstition_Mountain_-_Sequencing_Map


Milling / Pavement Removal:

While Milling and Pavement Removal does not cause any extended access restrictions, you may experience delays if you are caught behind the equipment, or are trying to exit your village while the equipment and crews are milling SMD.

In addition, as we begin work in some of the villages, where roads are narrower and alternative access doesn't exist, access in and out of your home may be delayed longer than those impacted by the work on Club Village Drive.

Utility Adjustments:

Adjustments will begin July 14, 2025. Manhole covers will sit adjacent to the removal location until the project is complete. Then crews will return, and replace the utility equipment the week of July 29, 2025.
